1. Project

1.1. Introduction

In the last few years we have seen a new computing area that is becoming increasingly relevant in today’s IT ecosystem. This area is called the Cloud.

Cloud technologies are a new paradigm of computing that totally changes the way we have been thinking about computers. John Gage’s 1984 prophetic phrase “The network is the computer“ is now becoming more real than ever. In fact, we can hack it an actualize it to a more contemporary version. Now, the cloud is the computer. And with such a gigantic step on how we deal with computers it is inevitable to be interested in.

Cloud technologies can come in many forms. However we can classify the main types of cloud services as:

  1. Infrastructure as a service (IaaS) Where the provider offers dynamic access to computers, typically virtual machines, and other related resources such as storage, messaging, etc... This is the lower level form of cloud services. An example of IaaS is Amazon EC2.
  2. Platform as a service (PaaS) Where the provider offers a higher level platform typically including an operating system, a programming language execution environment, a database, and a web server. An example of PaaS is Google App Engine.
  3. Software as a service (SaaS) Where the provider offers application level software. Whereas IaaS and PaaS services are low level services addressed to be building block to construct other services, SaaS services are usually addressed to be used directly by final users. An example of SaaS is Salesforce.

This service classification is done from lower to higher level. In fact, higher level services are often built using lower level services. However, all these implementations share a common set of technologies and procedures.

Cloud technologies are heavily based on virtualization and autonomic computing. With the help of them the cloud infrastructures can leverage existing commodity hardware, lower costs and ease its usage. This way, the entrance barriers to create new projects are lower than ever.

In this project we will focus both in virtualization and autonomic computing as we want to use the IaaS services capabilities to automate the behavior of an IT deployment. We want to create a system that is able to enlarge or reduce a cluster based on certain performance events.

1.2. Motivation

During my latest career years I have been involved in many projects related to J2EE and web technologies. I have been specializing in systems administration with a special love for high availability and performance matters. With the raise of the cloud technologies I have been interested in how joining the J2EE and cloud stacks can provide flexible, performant and reliable environments.

Until now when you had to provision an environment you had to keep in mind the maximum number of concurrent users and then do an appropriate hardware sizing that is able to handle the load. Besides that, there were other concerns as the high availability matters.

Finally, what usually happens is that you end up with some very big computers that have costed a lot of money and are often underused. This approach is inflexible and expensive.

It can happen that your application has got utilization peaks that happen a few times a week but you don’t know when. In pre cloud deployments you would be tied to have servers big enough to handle the utilization peaks but that would be mostly underused.

One of the big points of the cloud service providers is the pay as you go schema. This feature together with the ability to start and stop servers on demand can help you reduce the deployment costs thus enabling the environment to automatically respond to the user load behavior.

1.3. Project description

This project aims to create a system that is able to horizontally scale a J2EE based environment when certain OS or JVM thresholds are reached.

To achieve this goal we will build a service that is able to gather performance statistics of a number of machines and execute actions when certain events are reached. The events are can be performance thresholds or system events. The actions are the steps needed to provision a new cluster node and integrate it into the cluster.

There are different components that must be created:

  • A remote performance monitor
  • A performance counters analyzer that is able to apply some business logic
  • A module to automate the deployment of a new virtual machines
  • A module that is able to provision the virtual machine
  • A module that is able to integrate the virtual machine in an existing cluster
  • A module that execute remote tasks

1.4. Objectives

The objectives that we are trying to achieve with this project are:

  • Create a tool that is able to enhance scalability capabilities of a cloud based J2EE environment.
  • The tool itself must be deployable on a cloud environment and have high availability and scalability features.
  • Gain knowledge on cloud architectures
  • Learn how to use an IaaS provider and its API
  • Use provisioning tools to automate the  deployment of a cluster
  • Understand the performance metrics of a J2EE server
  • Be able to create a business logic that is able to analyze events over time
  • Although the tool is aimed to analyze J2EE performance metric and make use of one specific IaaS provider it should be designed to easily deploy new performance counter sources and IaaS providers

1.5. Methodology

This project is designed using the DevOps approach to IT management. DevOps is a software development method that stresses communication, collaboration and integration between software developers and information technology (IT) professionals. DevOps is a response to the interdependence of software development and IT operations. It aims to help an organization rapidly produce software products and services.

Some of the DevOps key points are:

  • Use of agile and other development processes and methodologies
  • Usage of virtualized and cloud infrastructure from internal and external providers
  • Usage of data center automation and configuration management tools
  • More frequent and faster deployments
  • Deployment flexibility

1.6. Risk analysis

The main risks associated with the project are the following. We provide, as well, an associated action designed to avoid them or, if they do not achieve it, alleviate it.

RISK PROBABILITY IMPACT ACTION
Too many technologies and components to manage and integrate. High High
  • Design the environment as simple as possible.
  • Focus on a single IaaS environment.
  • Focus on a simple J2EE server and application to deploy
As the application will be used in a public cloud provider with costs associated to the server time usage High Medium Develop when possible with local servers and the use paid services only to test when needed
The complexity of the project and the tight schedule High High Define a realist project schedule and try to follow it as strictly as possible

1.7. Scope

Although the service is aimed to be open, modular and expandable due to time constraint we need to focus on certain premises.

  • Integration with only one IaaS service
  • Scale one J2EE container
  • Scale one J2EE application
  • Scale one web server frontend

1.8. Planning

The project has got the following organization.

1.8.1. Activities

The project is divided in the following activities:

  • Analysis
  • Design Design the solution
  • Proof Of Concept Create an initial POC to ensure the proposed solution is valid
  • Development
  • Monitoring module Create the module that monitors the environment to be scaled
  • Control module Create the module that handles the application business logic
  • Action module Create the module that triggers the scalation
  • Deployment
  • Virtual machine deployment Automate the deployment of new computers
  • J2EE Application provisioning Automate the J2EE application cluster deployment
  • Web server integration Automate the clustered web server configuration
  • Testing Quality assurance
  • Documentation Document the project

1.8.2. Human resources

The following profiles are needed to achieve this project

  1. Analyst. Defining and documenting the project
  2. Developer. Develop the server
  3. Systems Administrator. Integrate the server with the existing IaaS provider and provision the application to be scaled
  4. Test Engineer Perform the quality assurance and testing processes to ensure the correct behavior of the service

1.8.3. IT Resources

The project will be mostly developed on local development computer. However, to truly test the service we will use an online IaaS provider (Amazon AWS).

1.8.4. Effort estimation

The project timings are tied to the UOC semester timings and constraints. Because of that, we try to align the beginning and end to the academic course. We assume working from Monday to Friday and skipping the public holidays.

The following table contains the project calendar and assigned resource per activity.

TASKS INIT DATE END DATE DAYS RESOURCE
Analysis
Design 14/03/2013 27/03/2013 10 Analyst
Proof of concept 2/04/2013 15/04/2013 10 Developer
Development
Monitoring module 16/04/2013 29/05/2013 10 Developer
Control module 30/04/2013 14/05/2013 10 Developer
Actions module 15/05/2013 21/05/2013 5 Developer
Integration
Virtual machine deployment 22/05/2013 27/05/2013 3 Systems Administrator
J2EE application deployment 28/05/2013 30/05/2013 3 Systems Administrator
Web server Integration 31/05/2013 31/05/2013 2 Systems Administrator
Testing 3/06/2013 14/06/2013 10 Test Engineer
Documentation 17/06/2013 21/06/2013 5 Analyst

The TFC subject has got 7,5 credits and each credit should have around 25 hours of dedication (25x7,5 = 187,5). Based in that calculation we have defined the following daily effort.

TOTAL TIME
Days 68
Hours/day 3
Hours 204

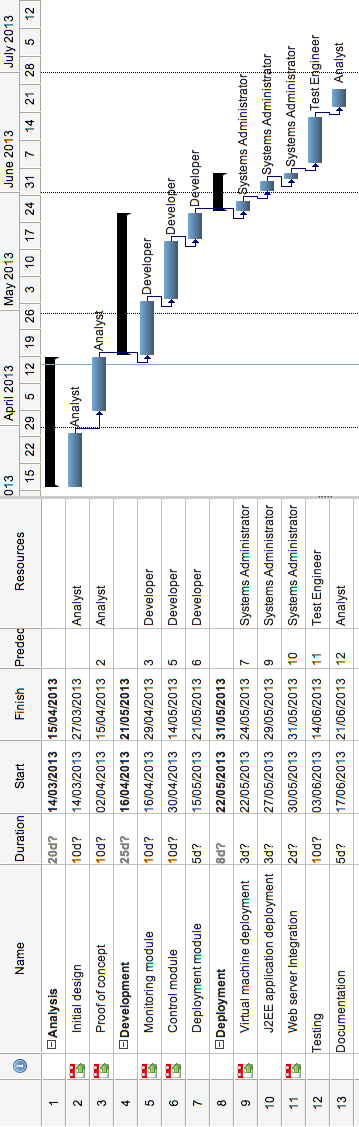

The following image is the project’s Gannt diagram.

1.9. Economic evaluation

There are two type of costs associated with the the project, human and computing resources.

The human resources costs are based detailed in the following table:

COSTS HOURS RATE/HOUR COST
Analyst 45 50€ 2250€
Developer 105 30€ 3150€
Systems Administrator 24 35€ 840€
Test Engineer 30 30€ 900€
    TOTAL 7140€

The initial computing resources are already in place as we own the development computer.

To test the service on a cloud environment we need to contract the services of an IaaS provider. However, we will use the Amazon AWS Free Usage Tier so it should be free while developing the project.
